Barge Complex Planned Projects

Port of Benton Electrification Project

Port of Benton has received a Port Electrification Program Grant to support the installation of zero-emission shore-side power infrastructure at its Barge Complex in North Richland. This initiative will expand the port’s mooring capacity, provide modern shore-power connections for a wider range of vessels, and help meet growing demand from current and future maritime customers. By reducing emissions and supporting cleaner, more efficient operations, the project strengthens the port’s long-term sustainability and enhances its ability to serve commercial, industrial, and passenger vessel users. PND Engineers has been selected as the design firm, and project development is actively progressing.

Completed Work (as of March 2026)

The Port of Benton has completed several major technical and site-assessment activities to advance the electrification project. This includes the critical JARPA submission to the U.S. Army Corps of Engineers on April 1, 2026.

Key milestones completed to date include:

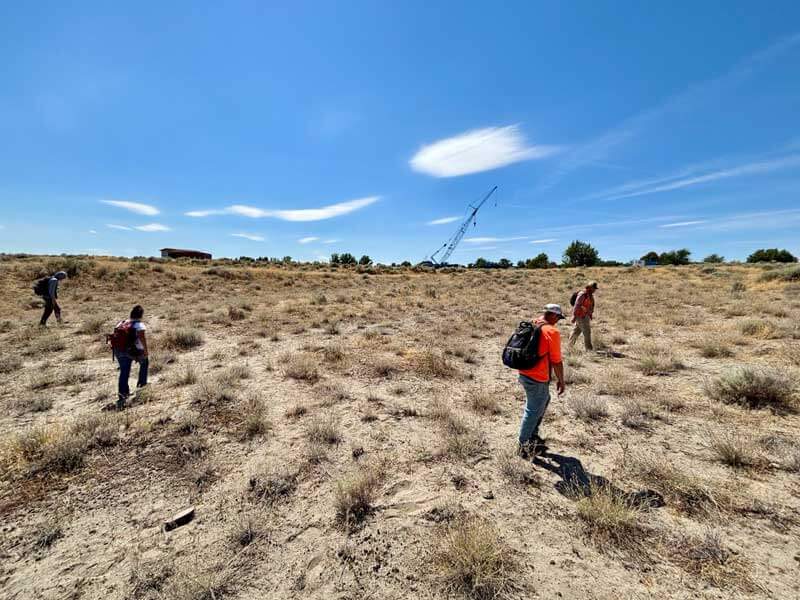

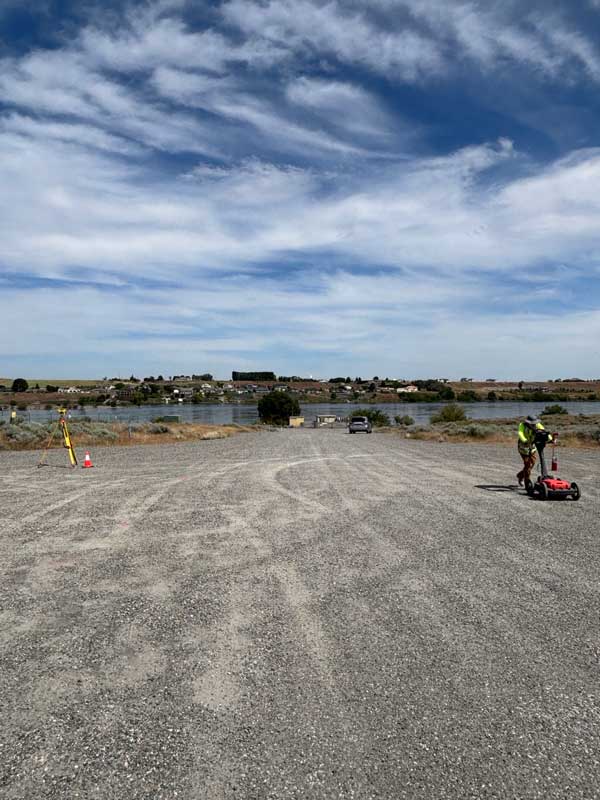

  • Upland and bathymetric surveys to document existing site conditions both onshore and within the waterway.
  • Low, normal, and maximum pool elevation calculations to ensure reliable system performance under varying river levels
  • Cultural resource assessment to meet regulatory and permitting requirements

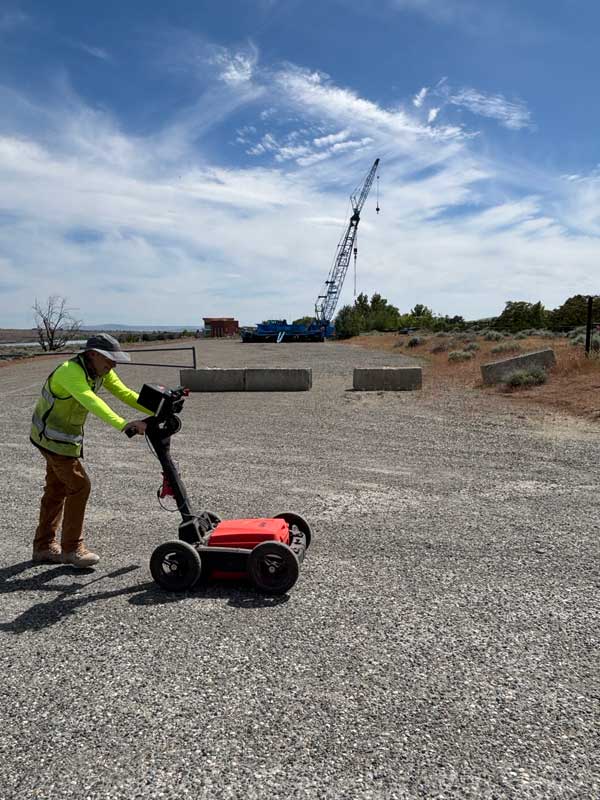

  • Geotechnical investigations to determine subsurface conditions and inform pile and foundation design

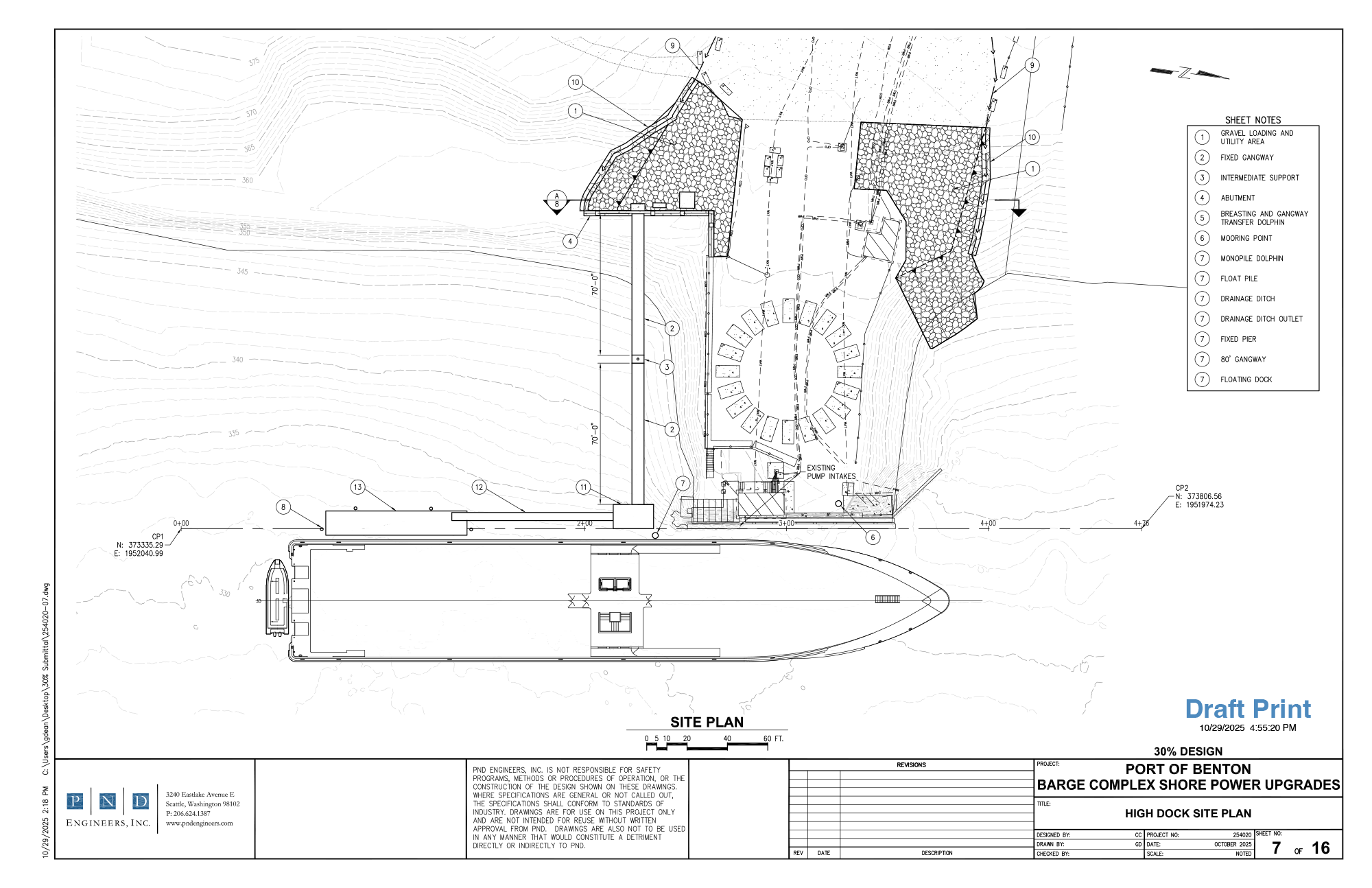

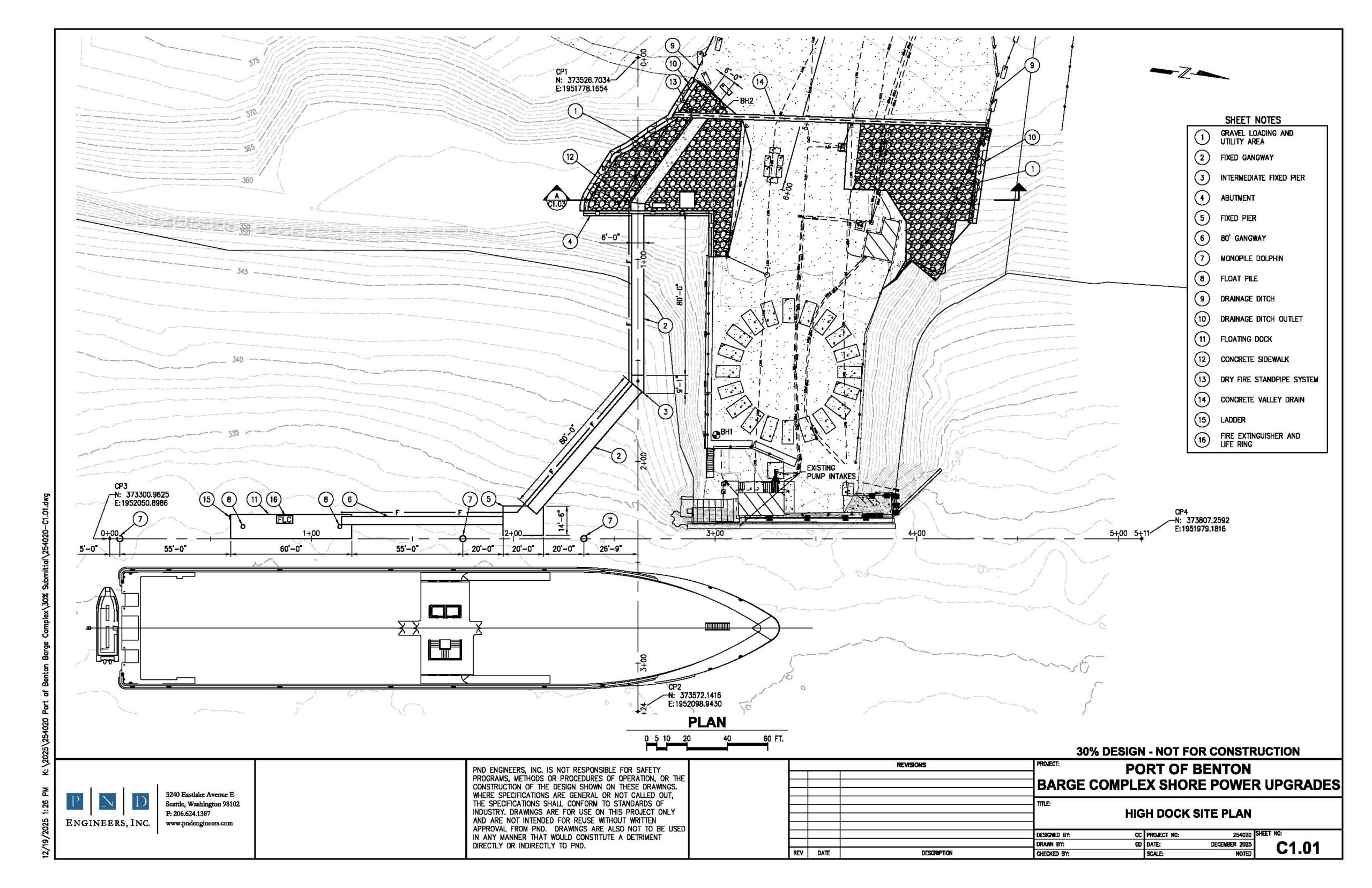

  • Preliminary siting and layout development, with 30% design plans currently under stakeholder review
  • Corrosion assessments and dive inspections at the High Dock to evaluate structural conditions
  • Coordination with the City of Richland regarding shoreline impacts
  • Completion of a critical areas survey
  • Fire line investigation and coordination
  • JARPA submission to the U.S. Army Corps of Engineers


After evaluating multiple options, the high dock was selected as the preferred location for delivering shore power. This site offers the best overall value, flexibility, and long-term usability. The deployment concept includes in-water components, such as new piles, a gangway, and a floating platform capable of supporting a wide range of vessels, from large Columbia River cruise ships to smaller tugboats, maximizing operational efficiency and compatibility.

Next Steps

Upcoming project milestones include:

  • Submission of permit applications. Due to the project’s location along the Columbia River, in-water construction is limited to specific seasonal work windows, requiring careful planning
  • Completion of 90% design documentation, including detailed plans, specifications, and cost estimates
  • Development of corrosion protection plans, specifications, and cost estimates for the High Dock facility
  • Material scoping and procurement strategy led by PND Engineers to identify long-lead items and evaluate direct procurement opportunities to reduce costs and minimize on-site construction time



The construction schedule will continue to be refined as design and permitting progress. The current target is to begin upland construction in Q3 2027.

For additional information or questions, please contact the Port of Benton.

Supporting the Community’s Vision

This project would support the state’s 100% carbon-free electricity mandates and our shared Tri-Cities vision of being a model for a net-zero emissions community.

Green Corridor Supporting Growing Our Industries

Port of Benton’s barge complex offers many advantages for the region’s vast industry. The barge complex is in Richland, Washington, at River Mile 343 and is part of the M-84 green corridor connected to markets throughout the Northwest via the Columbia River.

Connected ports include Vancouver, Kalama, Longview and Clarkston in Washington and Portland, Oregon. Goods access intercoastal barge traffic via the Northwest Seaport Alliance ports of Seattle and Tacoma.

Project Schedule

This project is currently in the design phase. Permitting is estimated to take approximately 12 months from the time of submission. The in-water work window is planned for November through February, with a target of being construction-ready for the 2026/2027 window. Final project completion will follow that phase.

Project Funding

Port of Benton received a Port Electrification Program Grant via the Washington’s Climate Commitment Act (CCA), through the Washington State Department of Transportation to fund this project.

The CCA supports Washington’s climate action efforts by putting cap-and-invest dollars to work reducing climate pollution, creating jobs, and improving public health. Information about the CCA is available at www.climate.wa.gov.

News & Updates

Sign up to receive Port news and updates in your inbox.
Geotechnical Work
Cultural Assessment
Survey

Barge Facility Improvements

The Port is actively contracting for design and updates to the barge complex along the Columbia River in north Richland.

This construction project will enable the facility to accept larger brake-bold shipments and create additional moorage as a location for river cruise ships.

Projected Schedule

The project is currently in the design phase. Permitting, including the JARPA process, is expected to take up to 12 months from the time of submission. Due to environmental regulations, in-water construction is limited to a seasonal work window from December through February. As a result, the project is targeting readiness for construction following completion of permitting and design, with upland construction anticipated to begin in Q3 2027. In-water construction will be scheduled within the next available approved work window after permits are secured. Final project completion will follow the construction phase.
